Connectivity

Digital infrastructure needs digital connectivity

Telstra returned an explicit major cable and optic fibre warning for the search area, NBN separately identified communications assets, and on 5 September 2026 Telstra’s own warning post was photographed on the holding’s fence line reading “optical fibre cable in this vicinity”. The presence of carrier fibre at the boundary is now confirmed by the asset owner’s signage. It does not make the site carrier ready.

An intercapital trunk route through this corridor has not been established and should not be claimed until a carrier confirms it. The fibre and connectivity questions in the FAQ →

The evidence

What the carriers said

“WARNING — MAJOR CABLES and/or OPTIC FIBRE IN THE AREA.” Telstra NSW South, Before You Dig Australia response, 26 August 2026. The detailed asset plan was not included in the consolidated response document and should be obtained separately.

NBN asset search results returned “Communications: Asset identified” and “Electricity: No assets”, confirming telecommunications facilities in the vicinity independently of Telstra.

Seen on the ground, 5 September 2026

A walk of the fence lines found Telstra’s own markers. A yellow warning post at a gate reads “optical fibre cable in this vicinity”, which is the asset owner naming the asset type in the field, something the BYDA response did not do. A series of numbered triangular markers gives the route direction along the fence and the offset to the cable, and an older Telecom Australia marker records the cable at 1.2 metres deep. The Telecom branding dates that route to before 1995, which suggests a long-established route rather than a recent local access build, and is the single most encouraging thing the inspection found. It is still not a capacity, a strand count or a second route.

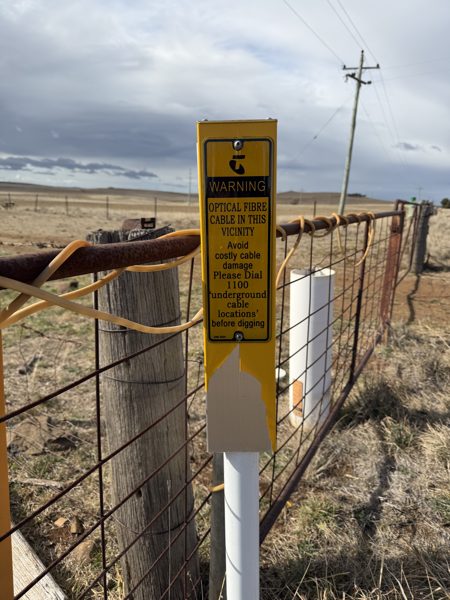

A yellow Telstra warning post fixed to a farm gate reading Warning, optical fibre cable in this vicinity, with open grazing land and a timber power pole behind.
Telstra optical fibre warning post at a gate on the holding’s fence line: “Warning. Optical fibre cable in this vicinity.” The asset owner’s own signage, placing an optical fibre cable on the boundary. Photographed 5 September 2026.

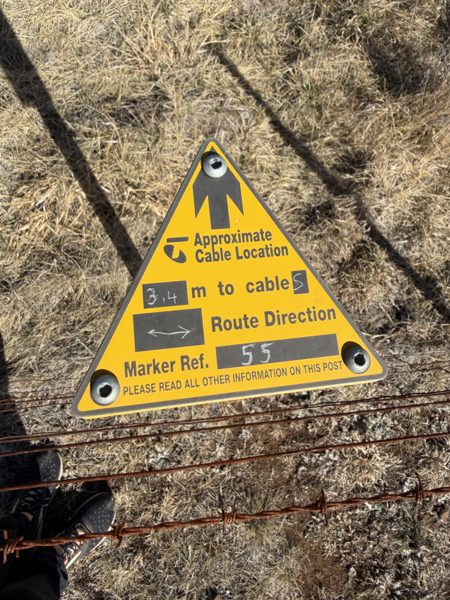

A yellow triangular Telstra cable marker on a fence post reading approximate cable location, 3.4 metres to cable, route direction along the fence, marker reference 55.
Telstra cable marker 55. Reads 3.4 m to cable, with the route direction arrow running along the fence line. One of a series of numbered markers photographed along the boundary.

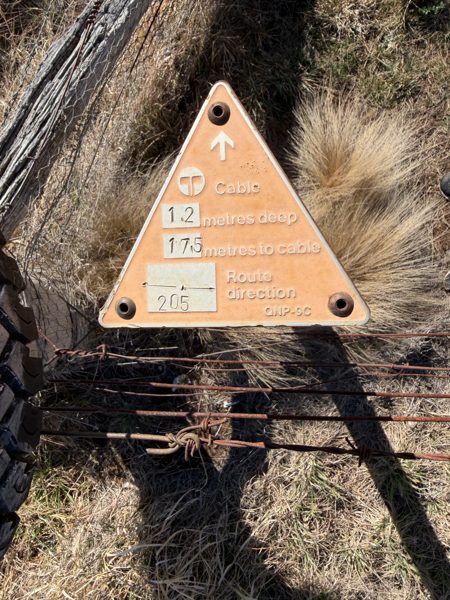

An older orange triangular Telecom Australia marker reading cable 1.2 metres deep, route direction 205, marker type QNP-9C.
Telecom Australia era marker. Cable 1.2 metres deep, route direction 205. The pre-1995 Telecom branding suggests a long-established route rather than a recent local access build. Route role, strand count and capacity remain for Telstra to confirm.

Photographs 5 September 2026, reproduced without alteration other than cropping and resizing. Marker positions are on the fence line and have not been surveyed.

What a utility location service does not establish

Before You Dig is a utility location service, not a capacity service. These responses establish the presence and ownership of infrastructure. They do not establish fibre type, spare capacity, route role, diversity, connection cost or connection timing. Each of those requires a separate commercial enquiry to the carrier concerned. Telstra plans are valid for 60 days from issue.

What must be established

  • Dark fibre and wavelength service availability
  • Actual route role: is it a trunk, a backhaul route or local access
  • Spare capacity, nearest splice point and carrier PoP locations
  • Latency to Canberra, Sydney and Melbourne
  • Route ownership and build distance for a second carrier
  • Lead times and augmentation costs

The requirement that decides it

Two physically diverse fibre paths entering the campus from separate directions. A single high capacity route, however good, is insufficient for a major deployment.

The target is Carrier 1 plus Carrier 2, on physically diverse routes, with scalable multi-terabit capacity. Establishing what the identified infrastructure can actually deliver for a large digital load is a defined and tractable diligence exercise, and one a prospective operator or partner would ordinarily lead.

Distance~126 kmCanberra by road on the Monaro Highway
Distance~406 kmSydney by road
CounterpartiesTelstra +1Telstra InfraCo or Wholesale, plus at least one independent carrier for diversity
StatusGatingServiceability unproven; one of the two workstreams that governs the project

Source: Before You Dig Australia infrastructure enquiry responses for the investigated area, Job 54074165, including Telstra NSW South and NBN Co. Such records identify the presence of assets in an area and are indicative only; asset locations, capacity and availability must be independently confirmed.

From “nearby” to engineering evidence

The carrier and fibre feasibility report

Performance measure 12 of the NSW Data Centre Guidelines requires early engagement with telecommunications and optical fibre providers, including opportunities to share a common bank of underground conduits. The work already done identifying telecommunications infrastructure is therefore valuable. It is not yet the document an operator will ask for.

An operator or a counterparty's technical adviser will put nine questions, and the answer to each has to come from a carrier rather than from a location plan. Together they define a formal Carrier and Fibre Feasibility Report, which is the deliverable this workstream now has to produce.

The nine questions a carrier and fibre feasibility report must answer, and the current position on each
QuestionCurrent positionWho answers it
CarrierTelstra assets flagged; NBN assets identified. No other carrier established.Telstra InfraCo or Wholesale; at least one independent carrier
Fibre typeOptical fibre, per Telstra’s warning post on the boundary. Strand count, generation and whether the sheath also carries copper are not established.Telstra, from the detailed asset plan
Available strands and capacityNot established.Carrier serviceability assessment
RouteMarked on the ground along the fence line by numbered Telstra markers with route direction and depth (1.2 m). No route plan has been supplied; the corridor is drawn indicatively on the interactive plan for that reason.Carrier route maps
Distance from site boundaryNot established.Carrier, against the cadastral boundary
Latency to SydneyNot measured. Geographic position between Canberra, Sydney and Melbourne is favourable; carrier performance is not.Carrier, indicative then tested
Physically diverse second routeNot established. One corridor is strongly indicated; a second is not.Second carrier, with route maps proving separation
Cost to extendNot established.Carrier build quotation
Lead timeNot established.Carrier
The standard the report has to meet

For a hyperscale opportunity, two genuinely diverse fibre paths are essential, not desirable. Diverse means physically separate routes entering the campus from different directions, with no shared conduit, pit, bridge crossing or point of failure between them. A report that establishes one excellent route and gestures at a second has not answered the question, and this is one of the two gating items that governs whether the project proceeds at scale.

The key facts

What rarely sits on one holding, and what each fact does not yet establish
